Milton Regis Viaduct
The century-old viaduct requires specialist maintenance every two years which is usually funded through fares, sales and catering at the Railway but this reduces the amount of money we can spend on other projects. The work costs £20,000 and comes from fares, souvenir sales and catering at Kemsley Down.
Due to other commitments, our maintenance contractors require the line to be closed for three weeks, so there will be no trains on Sunday 26th April, Sunday 3rd, Monday 4th and Sunday 10th May 2026.
To help us fund Milton Regis Viaduct’s maintenance, please visit our Just Giving page and mention ‘Viaduct’ in the comments box so the money goes to the right fund. Any sum, no matter how large or small, will help – perhaps donate your fare if you would have visited us by now.
The rest of this page looks at this wonderful structure and previous maintenance works carried out.
Milton Regis Viaduct

Part of the mural at The Wall, Sittingbourne on the road to the Railway’s entrance

The entrance to Sittingbourne Viaduct station
From the mural at the entrance or the name of the station in Sittingbourne, Milton Regis Viaduct is a key part of the Sittingbourne & Kemsley Light Railway. It is a lasting legacy of the industrial railway that once linked the paper mills at Sittingbourne and Kemsley to Ridham Dock.
At about a kilometre long, with six bridges and 118 spans, the reinforced concrete viaduct is iconic in narrow gauge railway heritage.
It is also showing its age – over 100 years standing astride or alongside Milton Creek (salt water) and suffering the battering of the wind, rain and trucks, Milton Regis Viaduct costs £20,000 every two years in specialist maintenance. The sections that have been repaired look as good as new but there’s still a long way to go.
A few years ago, Kent County Council (KCC) lowered the road under Gas Road Bridge to enable more and taller trucks to serve a new industrial estate on the site of the former Milton Pipes works. During construction, there was an extended period of road closures resulting in lorries having to use the skew bridge, a bridge closer to Sittingbourne Viaduct station. This bridge, despite being sign posted as lower than Gas Road, was struck by numerous trucks and trailers which caused severe damage to the underside of the bridge.
KCC paid for the repair work to Gas Road Bridge and the Railway paid for the repairs to the skew bridge, with its neighbours agreeing to part block the road to prevent trucks from attempting to drive under the bridge.
In 2024, the first pass of the Viaduct maintenance programme was completed, this marked the completion of maintenance which started at the Kemsley-end of the Viaduct in 1996. The 2026 maintenance schedule will be focussing on hot spots identified by our structures engineer and then we will start all over again, from the Kemsley-end! It is to be expected that after 30 years, some previous repairs will need to be repaired and more damage will be found.
Interestingly, in 2024, for our structures engineer and the Office for Rail and Road, we cleared the top of the Viaduct deck so that its condition could be examined and it still bears the builders marks! It turns out that the use of old power station ash, rather than ballast, had kept the surface damp and covered so it was not subjected to the harshness of the weather and did not dry out and spall.

Gas Road after the road lowering scheme

The extensive damage to the underside of the skew bridge

The underside of the skew bridge after it was repaired

Leader on Milton Regis Viaduct approaching Sittingbourne Viaduct station with Bowaters coaches

Leader approaching Sittingbourne Viaduct station on Milton Regis Viaduct running parallel to the B2005 Mill Way. A redundant pipe bridge can be seen paralleling the Viaduct on the creek-side.

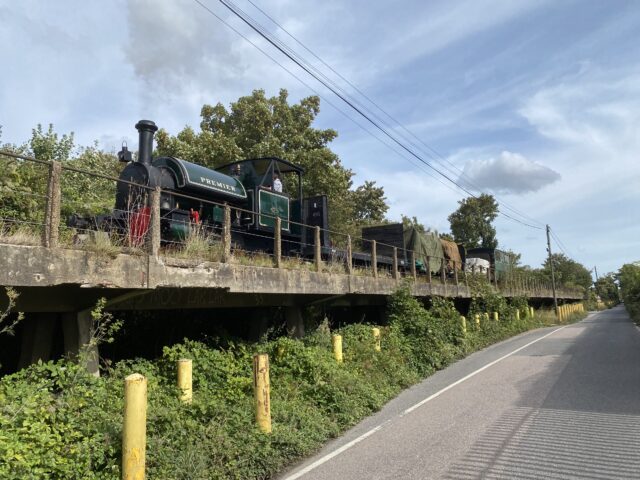

‘Premier’ passes over Milton Regis Viaduct above the industrial outskirts of Milton Regis

‘Premier’ hauls a train over the straight section of Milton Regis Viaduct, which runs parallel to Gas Road.
